First Phase of Kamoto Copper Project on Track for Production Start
Key mine components were ordered a year ago, the construction team build-up began in January 2007, and extraction commenced at the Kamoto underground and T17 open-pit mines in April. The 7.5- million-mt/y-capacity concentrator restarted in July and commissioning of the Luilu metallurgical plant got under way in September. Copper and cobalt output should start in the final quarter of 2007. Total reserves and resources (excluding inferred) are stated as 162 million mt at 3.5% copper and 0.38% cobalt, sufficient to support a mine life of at least 40 years at anticipated production rates. The average site cash costs, net of cobalt credits, are estimated at $0.20/lb copper, placing Kamoto close to the lower end of the global mine cost curve.

The Kamoto/Dima mining complex is one of a number of substantial copper operations that state-owned Gécamines was obliged to close. It comprises the Kamoto underground mine; the Dikuluwe, Mashamba East, Mashamba West and Musonoie-T17 oxide open pits; the Kamoto concentrator and the Luilu metallurgical plant as well as the related mineral properties. As the region’s political situation improved Gécamines sought to refurbish and rehabilitate the facilities, signing the Kamoto Joint Venture Agreement with Kinross-Forrest Ltd (KFL) to hold, redevelop, rehabilitate and operate the Kamoto JV Assets. The Kamoto JV received the approval of the Conseil des Ministres du Government de Transition of the DRC (the Congolese Government) on July 15, 2005.
The JV required that a feasibility study be delivered by KFL to Gécamines within eight months after the Kamoto JV has received all required regulatory approvals. This feasibility study, delivered in April 2006, projected a discounted rate of return on total capital invested to achieve a minimum of 150,000 mt of sulphide ore processed each month of not less than 20%. As per the JV terms, this enabled KFL and Gécamines to establish a DRC company to hold the Kamoto JV Assets. This is the Kamoto Copper Co. (KCC), initially 75% owned by KFL and 25% by Gécamines. KCC has a service agreement with Kamoto Operating Ltd. (KOL) whereby KOL purchases the equipment and materials for the project and was also to market and sell the production. Subsequently, Bermuda-based Katanga Mining Ltd. acquired KFL in stages, completing the deal and listing on the Toronto Stock Exchange in July 2006.
Katanga Mining, headed by Arthur Ditto, former president of Kinross Gold Corp., has offices in London, England. Katanga reports that capital investment in Phase 1 of the project, to first production, is $172 million. Phase 2, covering bringing roaster 1 online through 2008-2009 will require $97 million, and Phase 3, involving a second roaster and a dewatering program, will absorb $105 million. The final phase, costing $50 million, will take the operation to full rate production of 150,000 mt copper and 8,000 mt cobalt in 2011.
At the Kamoto underground mine, twin 6.5 x 6-m ramp declines provide access for trackless mining equipment and the shaft system can hoist 11,000 mt/d. Katanga Mining ordered a fleet of drilling, bolting, loading and haulage machines from Atlas Copco, including four Rocket Boomer 282 drifting rigs, four Boltec H235 machines, four Scooptram ST1520 LHDs and six Minetruck MT5010 haulers.

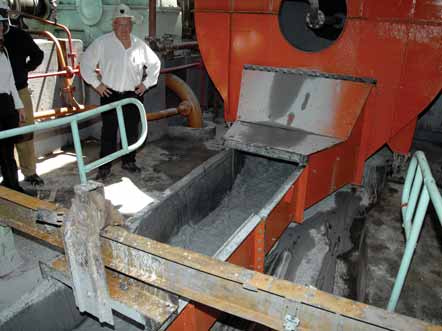

Work on the concentrator has involved South Africa’s Multotec in refurbishing the flotation plant. First, Multotec Zambia completed a detailed plant audit at the concentrator, making recommendations to the project manager Hatch as to how the rehabilitation should be carried out. The resulting supply contract included design of the level control system and delivery of the wetted parts of the new flotation mechanisms. A field service team assembled a prototype of the Wemco 120 unit in the concentrator to assist KOL personnel in setting up the rehabilitation process and later a Multotec commissioning team worked with operational and engineering personnel from the concentrator. Multotec will also train plant personnel on general inspection and maintenance issues on the flotation cells.
However, the target firm decided to review the strategic options open to it and in early October, having completed the review, Katanga Mining announced it had signed a term sheet for a $150-million one-year loan facility with Glencore International AG. The loan bears interest at LIBOR plus 4% payable upon maturity. During the one-year term, the loan is convertible at the option of Glencore into 9,157,509 (fixed number) common shares of the company. Katanga has the right to repay the loan at any time. The agreement also includes a ten-year offtake contract with Glencore for all the copper and cobalt production.
